Q-195 115kV line

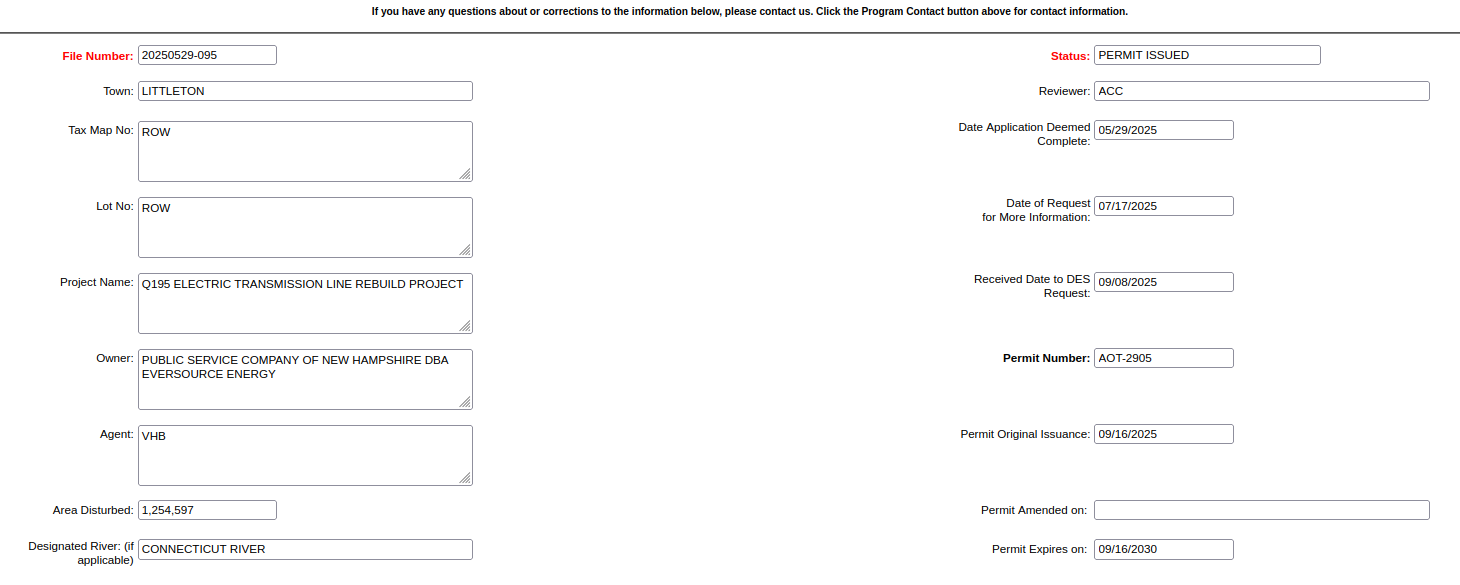

2023 May 18 PAC minutes, Replace 224 wood structures with 223 new steel structures, Re-conductor 17.5 miles of 336/477/795 ACSR with 1272 ACSS, Install 35 miles of OPGW (2 x 17.5 mi, Estimated PTF Cost: $100.00M (-25% / +50%), Projected In-service Date: Q4, 2026

2023, May 18 presentation to PAC

2023, February 28: "Dear Neighbor" letter

2022, June 30: complete DE-22-049 document listing E$ proposed spending

2017 river crossing poles fine

2017, December 14: assertion of 2015 assertion of crossing rights
