E-115 115kV Line $64 million
2023, March: request to NEPOOL for TCA

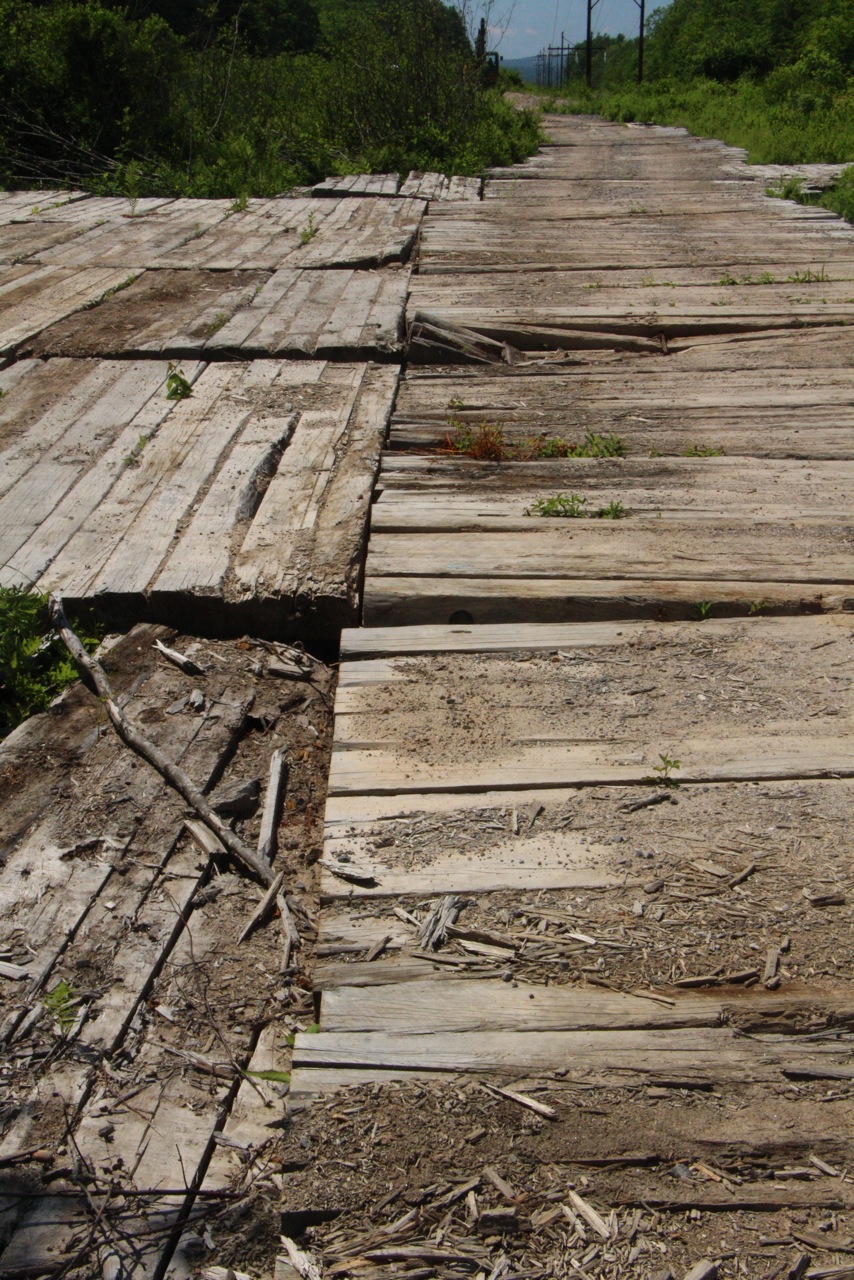

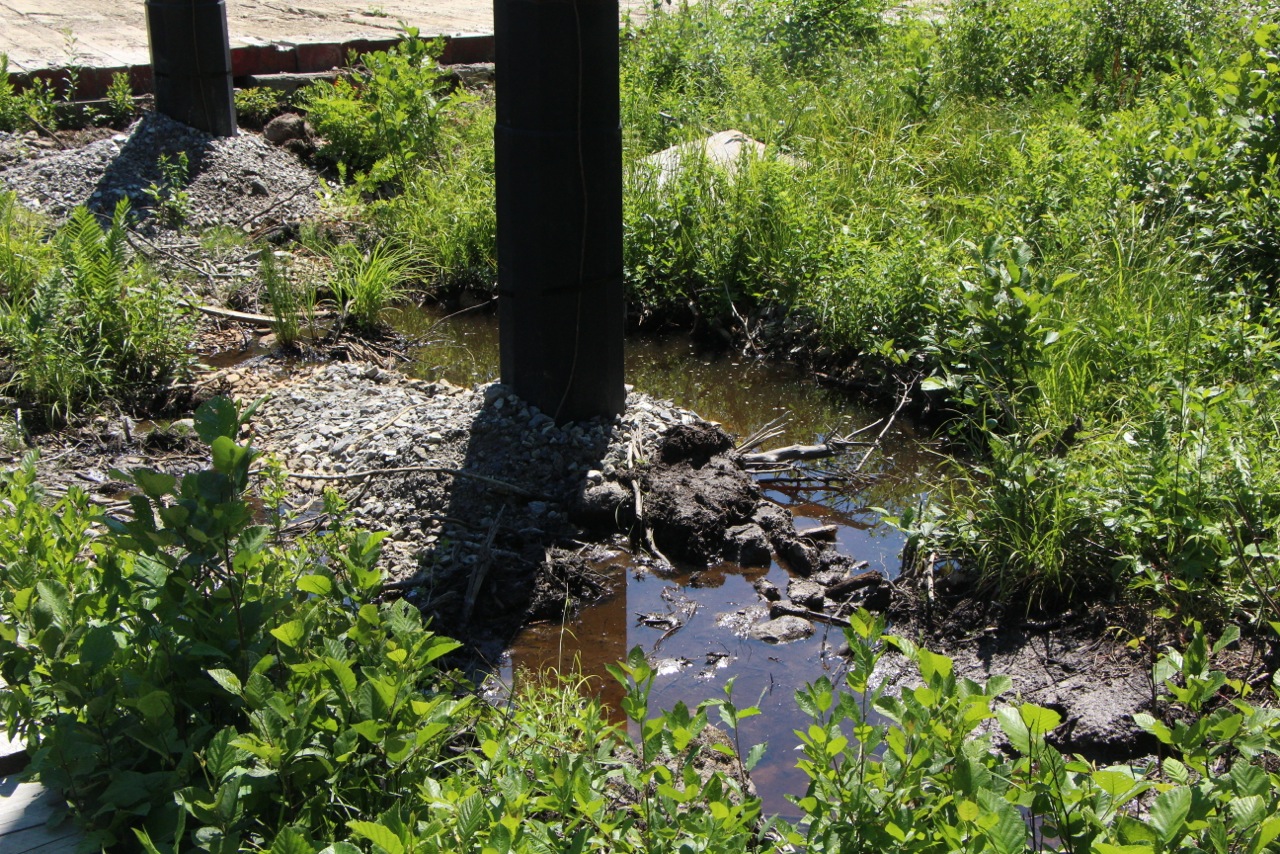

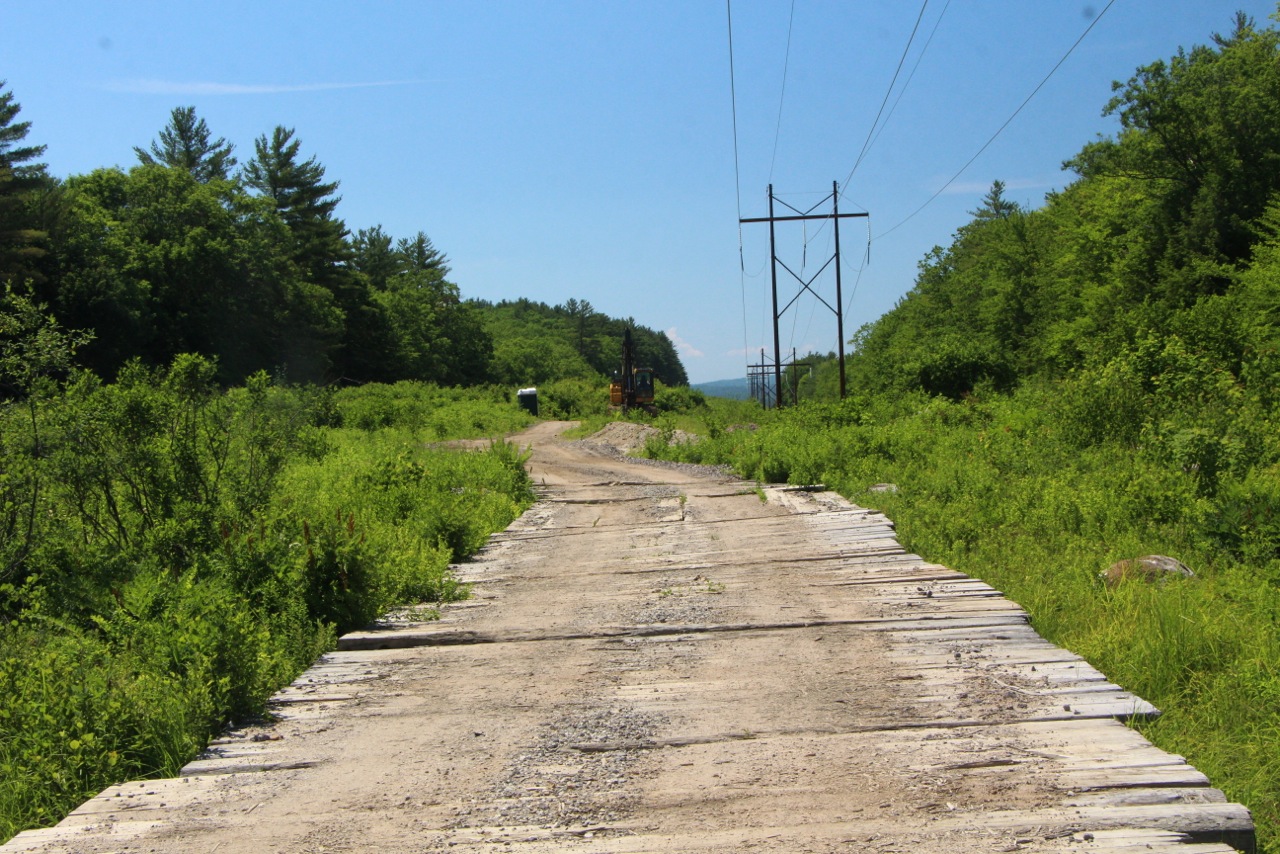

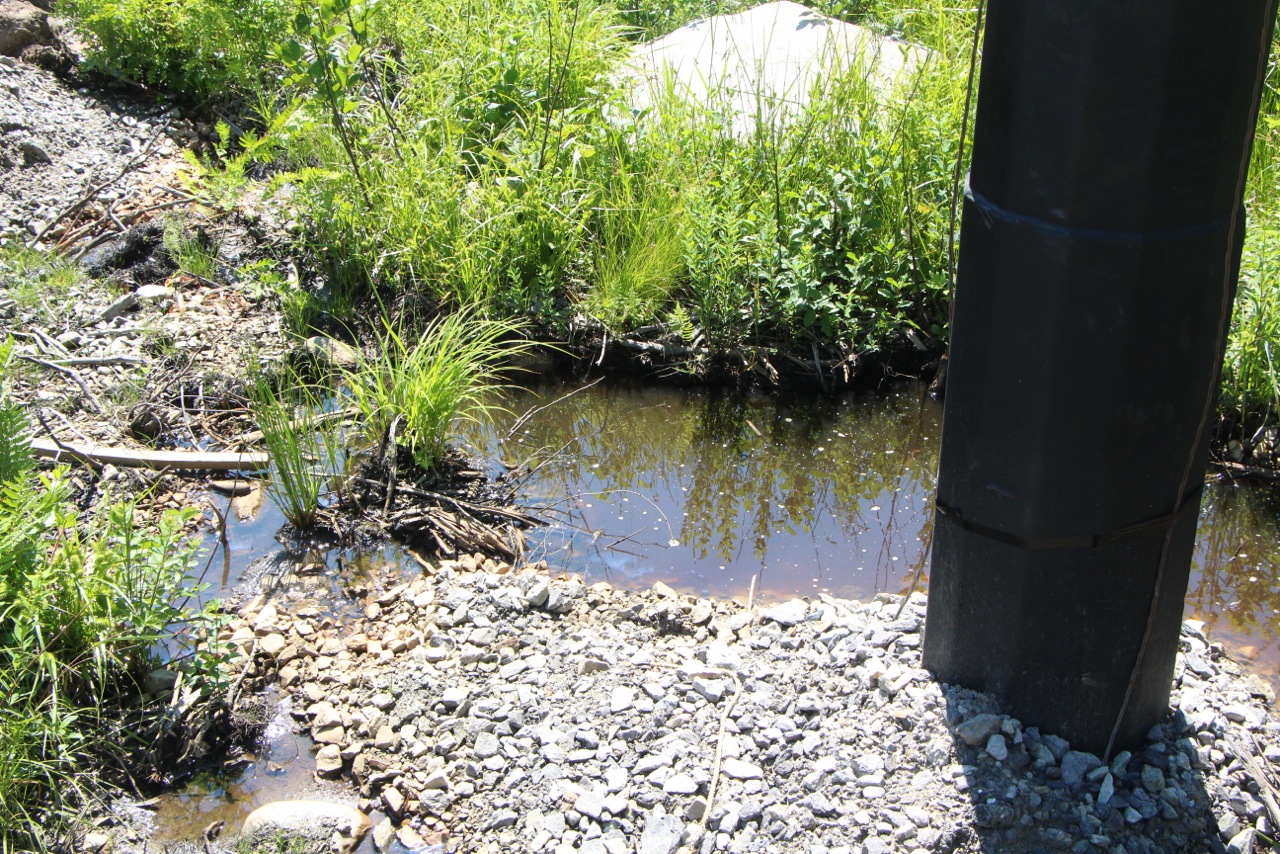

Road and wetlands matting on ROW and new structures, conductor and OPGW

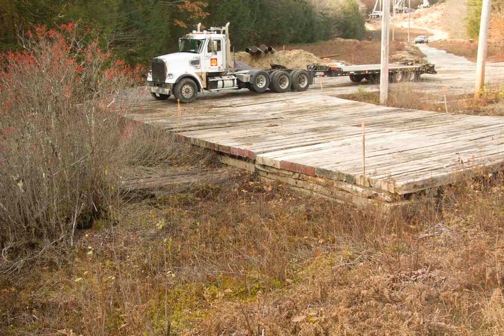

Large truck hauling flatbed on wetland matting and road in ROW.

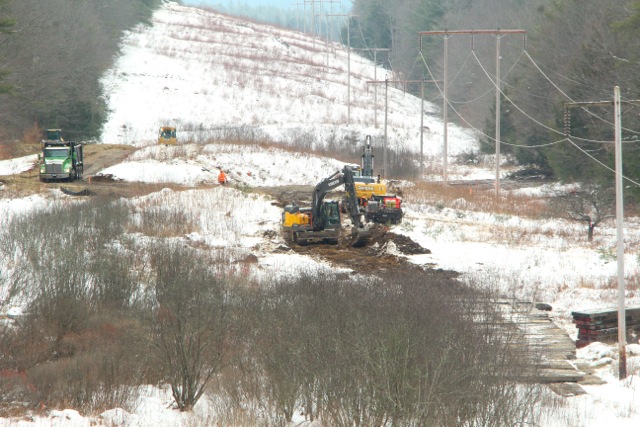

Excavator, gravel truck and other heavy machinery on ROW
2022, October 19; PAC presentation
2022, June 27: Eversource Transmission Cost Allocation application
2022, June 30: complete DE-22-049 document listing E$ proposed spending
2022, June 24: AoT permit plans amended
2022, June 30: complete DE-22-049 document listing E$ proposed spending
2022, June 23; start of construction letter
2022, May 12: Access and permitting plans
2022, April 22: DES permit with waivers
2022, April 22: Start of Construction
2022, March 1 AoT first page stamped
2022, February 21: Surface and Groundwater overlay maps, GZA
2021, July 15: no impact from interconnection
2021, March 9: inspection permit DES
2022, January 31: license granted
2021, January 14: order of notice
2022, January 10: staff recommendation
December 2021, petition attachments, 12/2016 original date, pole heights 52'-106'
2021, December 21: E$ petition for crossing

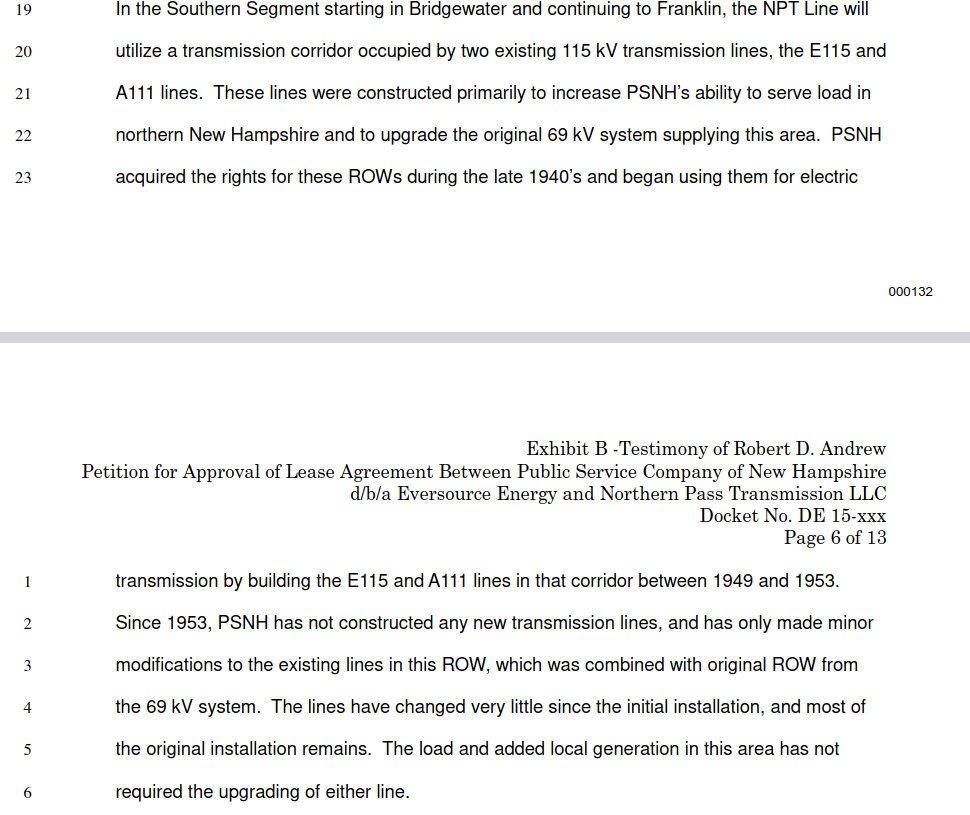

2017 river crossing rights exhibits
2017, December 14: assertion of 2015 assertion of crossing rights
