Pole height increases, WMNF, Lincoln, Woodstock, Easton and Sugar Hill
Site Evaluation Committee
Public Utilities Commission
Project Plans
Geotechnical drilling White Mountain National Forest
White Mountain National Forest documents
2025, May 14 (released) July, 2024 Forest Service: "Based
on feedback during the March 2024 meeting, and given Eversource has removed proposed access along Reel Brook Trail, we understand that the X178-2 project now potentially qualifies as a small project."
2025, May 9: Eversource plans to turn a section of the Reel Brook Trail (in blue), described by the Forest Service as "a well-established snowmobile trail," into a road for its proposed demolition and replacement of the X-178 line.

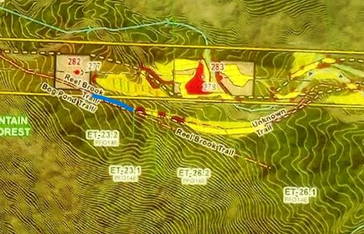

2025 May 9: map of Reel Brook Trail and Kinsman Ridge Trail re-locations, the former said by the FS to be unrelated to the X-178 proposed construction.
2025, April 28: letter sent to Forest Service re. inadequacy of a Categorical Exclusion for NEPA review of X-178 project
2025, April 16: NEPOOL Reliability Committee Consent Agenda; CANCELLED: "X178 Rebuild Project – Level I ***CEII TOPIC*** (PPA Applicant: Jaryn Vaile) Replacement of the 115-kV line X178 (X178-1, X178-2, X178-3) between the Whitefield Substation, Streeter Pond tap, North Woodstock Substation, and Beebe River Substation with 1272 ACSS 54/19 conductors. The proposed in-service date is December 31, 2026."
2025, March 26 (posted. Approved for consideration August 19, 2024): Forest Service proposed to give Eversource a Categorical Exclusion from NEPA requirements for an environmental assessment of Eversource's proposed X-178 line replacement, road and crane mesa construction in the Kinsman and Gordon Pond Roadless areas of White Mountain National Forest
2025, April 14: PUC schedule for Eversource petition for an exemption from Bethlehem's structure height restrictions
2025, April: Re-routing of Reel Brook Trail, apparently around the existing trail which Eversource plans to turn into a road with two cross-roads, to access the X-178
2025, March 31: Eversource request to withdraw X-178 from docket.
2025, March 28: Thornton to DES email re. landfill dump
2025, May 28: DES email re. Thornton dump landfill
2025, March 14: Eversource withdraws DES permit requests for geotechnical boring in WMNF.
2025, March 17: SEC Order taking jurisdiction of Eversource's proposed X-178 project.
2025, March 4: Counsel for the Public power-point presented at SEC hearing.
2025, March 4: Transcript of SEC Hearing
2025, March 3: PUC clarification on scope of docket.
2025, February 26: GZA response to questions about geotechnical boring in WMNF
2025, February 22: Comment on withheld documents
2025, February 12: Final summary of significant problems with Eversource's proposed X-178 rebuild
2025, February 11: Eversource to DES email re Thornton Dump Landfill borings
2025, February 11: GZA boring plan Thornton dump
2025, February posted on PAC site: 2024-12-20 Mass AG Comment on Eversource Local System Plan
2025, February 7: email re. incomplete application for geotechnical boring in WMNF
2024, February 5: Comment: Three questions and a request to the SEC
2025, February 2: Comment on Landownerless DES permits
2025, January 31: Comment on construction without a permit
2025, January 30: Comment on Eversource Errors
2025, January 24: Comment on AG and DES redacted "waiver" of landowner signatures on DES forms
2025-1-22: Start of Construction Notice for X-178 (2), Eversource to DES, released in a 91-a.
2025, January 23: Comment profile ACSS vs. ACCC
2025, January 22: Forest Service approves replacement of 5 structures on X-178 (1). No comment on permanent roads and construction mesas
2025, January 22: Forest Service project vicinity map, X-178 (1)
2025, January 22: Forest Service specialist review form, X-178 (1)
2025, January 22: Comment on information withheld by Eversource
2025, January 20: Statutory Permit by Notification for geotechnical borings of unstated depth on the X-178 easement in White Mountain National Forest."Threats to both the medium level fen system and poor level fen/bog system include changes to hydrology, especially those that result in pooling, increased nutrient input and increased sedimentation."
2025, January 19: Comment on structure age
2025, January 18: Comment on Eversource application for a Variance from Easton's structure height restriction
2025, January 7: Eversource application for a variance from Easton's structure height restriction.
2025, January: Eversource Site Plan Review application to Easton
2025, January 15: Comment on Eversource's application for a Condition Use Permit for Easton's Steep Slopes area
2025, January: Eversource application for a Conditional Use Permit for Easton Steep Slopes areas
2025, January 14; Comment on Eversource application for a Wetlands Conditional Use Permit
2025, January: Eversource application for a Conditional Use Permit for Easton's Wetlands Conservation District Overlay District
2025, January 9: Comment on lack of agency approvals or oversight of Eversource's X-178 project
2025, January 9: Comment on ACCC and ice loading
2025, January 7: Public Notice of Easton ZBA hearing on Eversource's request for a waiver from Easton's structure height restrictions.
2025, January 7: Eversource response to more questions on the X-178
2025, January 6: Comment on Eversource structure ratings
2025, January 6: More sizeable damages
2025, January 5: Comment; Conservation Biology; Effects of Roads on Animals, 2000
2025, January 4: Electricity as distinct from Intelligence
2024, December 30: Failure of Evidence by Eversource
2024, December 30: Views are not averaged
2024, November, Synapse questions to Eversource re. X-178
2024, December 29: Question on crossing specs.
2024, December 29: More apparent discrepancies
2024, December 28: Comment on Northern Pass restoration compared to X-178.
2024, December 27: Comment on NESC 250D
2024, December 26: When does E$ plan to return?
2024, December 24: Significant change
December 23: Eversource waivers from DES permit requirements
2024, December 22: X-178 structure replacement history
2024, December 21: U-199
2024, December 19: Comment
2-24, December 18: Annotation of Eversource statement
2024, December 17: Comment to SEC
2024, December 16: Comment to SEC
2024, December 14: Comment to CFP
2024: December: What appear to be Google street view photos of the X-178 easement and structures from various road locations. Produced by Eversource for the NH Site Evaluation Committee
2024, December: Profiles, 2022 (exhibit 2) and unlabeled 2024 incomplete structure inspection reports. Produced by Eversource for NH Site Evaluation Committee
2024, December: Visual impact mapping showing existing and rebuild POLE TOP visibility. 2022 structure inspection summary showing that 18 of the 43 structures Eversource claimed needed to be replaced had only hardware replacement needs. Produced by Eversource for the NH Site Evaluation Committee
2024, December: Alignments of structures. Produced by Eversource for NH Site Evaluation Committee
2024, December 20: Eversource-produced profile showing proposed conductor, OPGW, structures and terrain. For NH Site Evaluation Committee
2024, December 10: Eversource summary technical report produced for NH Site Evaluation Committee
2024, December 6: Utility Dive article of FERC penalty for utility witholding structure inspection reports
2024, November 28: Recently staked location for new structure 420, X-178 (3), at Route 116/18 below Gilmanton Hill Rd.
2024, November 21: NESCOE seeks power for itself, not to end the asset condition exploitation.
2024, November 23: Comment on DE-24-087
2024, November 19: NBC-CT episode on X-178, consumer costs and lack of oversight
2024, November 18: Information submitted to SEC

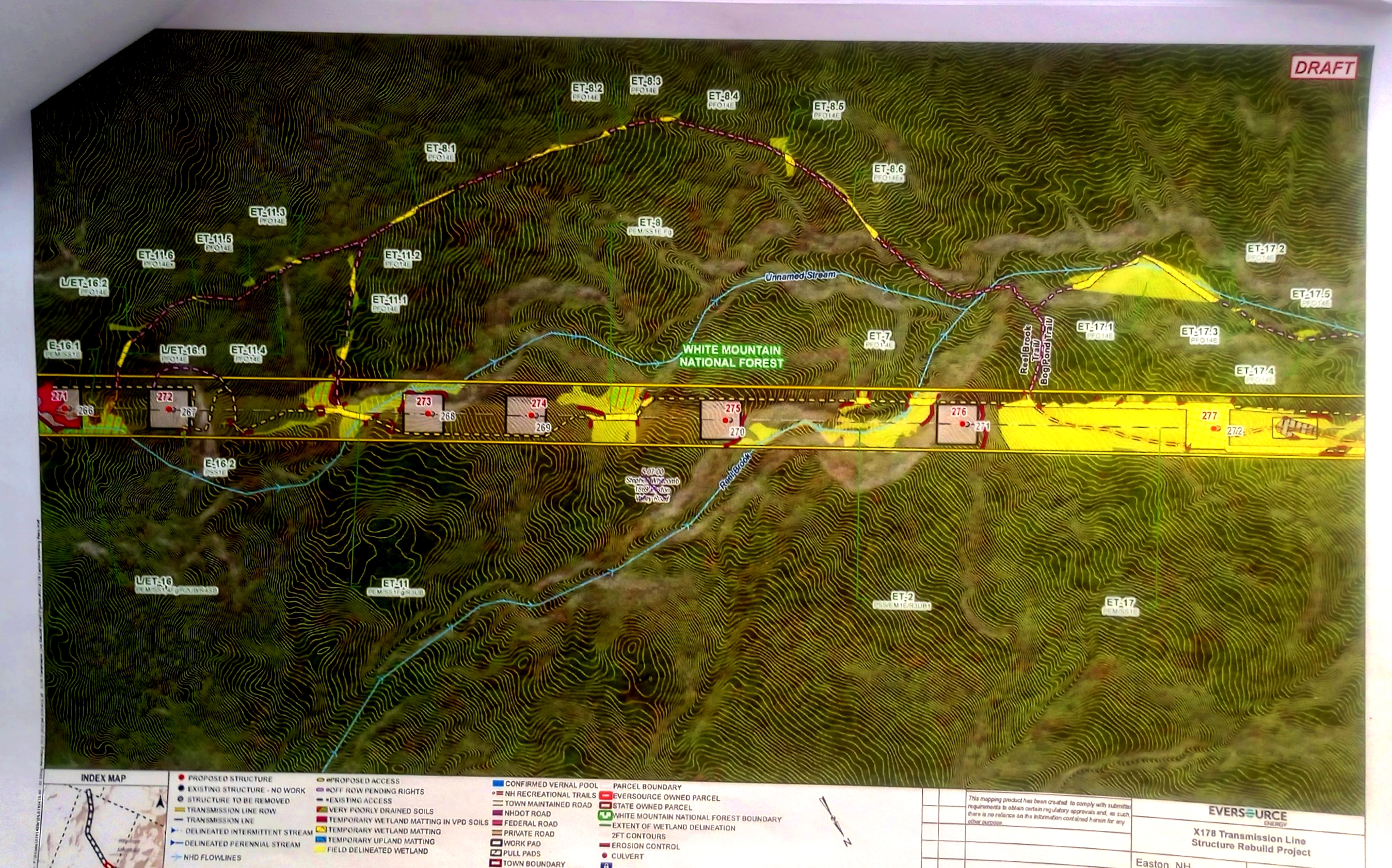

2024, November 18 (discovered): X-178 (2) Phase 2 permitting plans
2024, November 18: email and Eversource presentation on Thornton Landfill Dump. ACSS conductor not good for long spans. Code clearance for pedestrian areas 16'
2024, November 15: DES and Thornton emails re Thornton Landfill Dump
2024, November 13, NESCOE questions to Eversource re. X-178
2024, November 13: Connecticut OCA questions to Eversource on X-178
2024, November 4: kp comment to Forest Service re. inaccuracies in project description
2024, October 29: kp letter to PAC and Eversource re. U-199 and Q-195 as connecting to the Coos Loop
2024, October 23: Minutes of X-178 PAC meeting posted January 7, 2025.
2024, October 23: PAC presentation #4, same plan, 115 new Category C poles (as defined by Eversource) discovered. Eversource continues to refuse to provide the pole inspection reports to stakeholders.
2024, October 23: New template for "Asset Condition" projects with new, more aggressive recommendations for replacing Category B and C poles
2024, October 23: "Asset Condition" project template.
2024, October 16: Eversource response to criticism of its "proposal" to rebuild the X-178.
2024, October 3: Easton Planning Board minutes
2024, September 12: Road Grading White Mountain National Forest
2024, September 9: kp letter to Eversource and PAC re. missing information and September "informational" meeting
2024, September 8 (discovered on Eversource's site): Campton proposed" structure height increases.
204, September 8: Easton "proposed" structure height increases.
2024, September 8: Thornton "proposed" structure height increases.
2024, September 8: Lincoln "proposed" structure height increases
2024 September 8: Woodstock "proposed" structure height increases
2024, September 8: Sugar Hill "proposed" structure height increases
2024, September 8: (posted earlier): Bethlehem "proposed" structure height increases.
2024 September 8: Dalton "proposed" structure height increases.
2024, September 8: Whitefield "proposed" structure height increases
2024, August (received): post-construction grade of roads, pull pads and crane pads, Easton Phase 1
2024, August 22: Portland Press Herald; "Mainers could pay $32 million for grid upgrade in New Hampshire"
2024, August 19: InDepthNH article on X-178 lawsuit
2024, August 19: Consumer Advocates of New England letter to Eversource re.X-178
2024, August 16: Consumer Advocates of New England press release re. X-178
2024, August 12: Caledonian-Record article on the X-178; NESCOE and the SEC.
2024, August 12: Section 2, Phase 2 maps with 2' lidar-derived contour lines. White Mountain National Forest.
2024, August (received): post-construction grade of roads, pull pads and crane pads, Easton Phase 1
2024, August 12: ISO response to question on the absence of the X-178 from the asset condition list
2024, August 6 released by a 91-a: X-178 (2) Phase 1 Alteration of Terrain application, dated March 20 2024, permitted/approved 5/28/2024, permit good until 5/28/2029.
2024, August 6; released to the public by a 91-a: X-178 (3) approved Alteration of Terrain application
2024, August 6; released to the public by a 91-a: digital X-178-1 wetland permitting plans dated June 7, 2024
2024, undated redacted communication DES with DES Attorney Courtney Lockwood
2024, August 5: Easton Selectboard minutes
2024, August 5: kp letter to Eversource and DES re. continued failure to provide digital versions of AoT and Wetlands permit applications
2024, August 1: NESCOE letter to Eversource and ISO: "absent information showing that this use of consumer dollars is well-supported and reasonable, NESCOE is prepared to use its full resources to explore all available options to dispute the reasonableness of the investments, including but not limited to action at FERC."
2024, August 1: Easton Planning Board draft minutes
2024, July 24: DOE permit for X-178 crossings. DOE claims that the X-178 rebuild is necessary to meet the reasonable needs of service to the public.
2024, July 18: Caledonian Record
2024, July 18: DOE staff recommendation
2024, July 11: Eversource crossing application
2024: Eversource crossing exhibits and line profile drawings
2024, July 23: Revised AoT permitting plans
2024, July 17: email re. revised AoT permitting plans, 1
2024, July 17: Email re. revised AoT permitting plans, 2
2024, July 16: aquifer and wetlands
2024, July 15: Inquiry by InDepthNH
2024, July 11: draft minutes Easton Planning Board meeting with Eversource re site plan review
2024, July 8: Inquiry by InDepthNH
2024, July 8: Inquiry by InDepthNH
2024, July 8: Inquiry by InDepthNH
2024, July 8: Inquiry by InDepthNH
2024, July 8: DES responses to InDepthNH re. exclusion of easement-encumbered landowners from DES AoT and Wetlands permit applications
2024, July 6: email to Forest Service re. necessity for SOPA link to include Alteration of Terrain application.
2024, July 5: Inquiry by InDepthNH
2024, July 5: DES and NH AG conversation re. easement-encumbered landowner rights
2024: X-178 (3) undated email to LAC providing link to DES Wetlands permit application
2024: X-178 (2), existing and proposed structure heights, Bethlehem
2024, July 5: DES Commissioner Robert Scott forward to Philip Trowbridge, Jeffrey Blecharczyk and Micheal Schlosser complaint documents re. DES permitting process and Eversource regulatory failures in its transmission construction.
2024, July 5: kp email to DES, AG and others re. lack of landowner signatures on AoT applications.

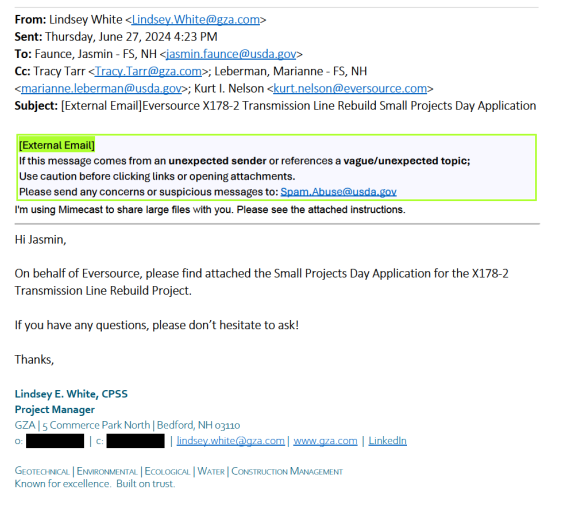

2024, June 27: Eversource submits to WMNF Small Projects Day/Categorical Exception from NEPA review for X-178 (2) Phase 2 construction through WMNF.
2024, June 24: follow up re. recommendations for X-178 (1) with link for Alteration of Terrain permit

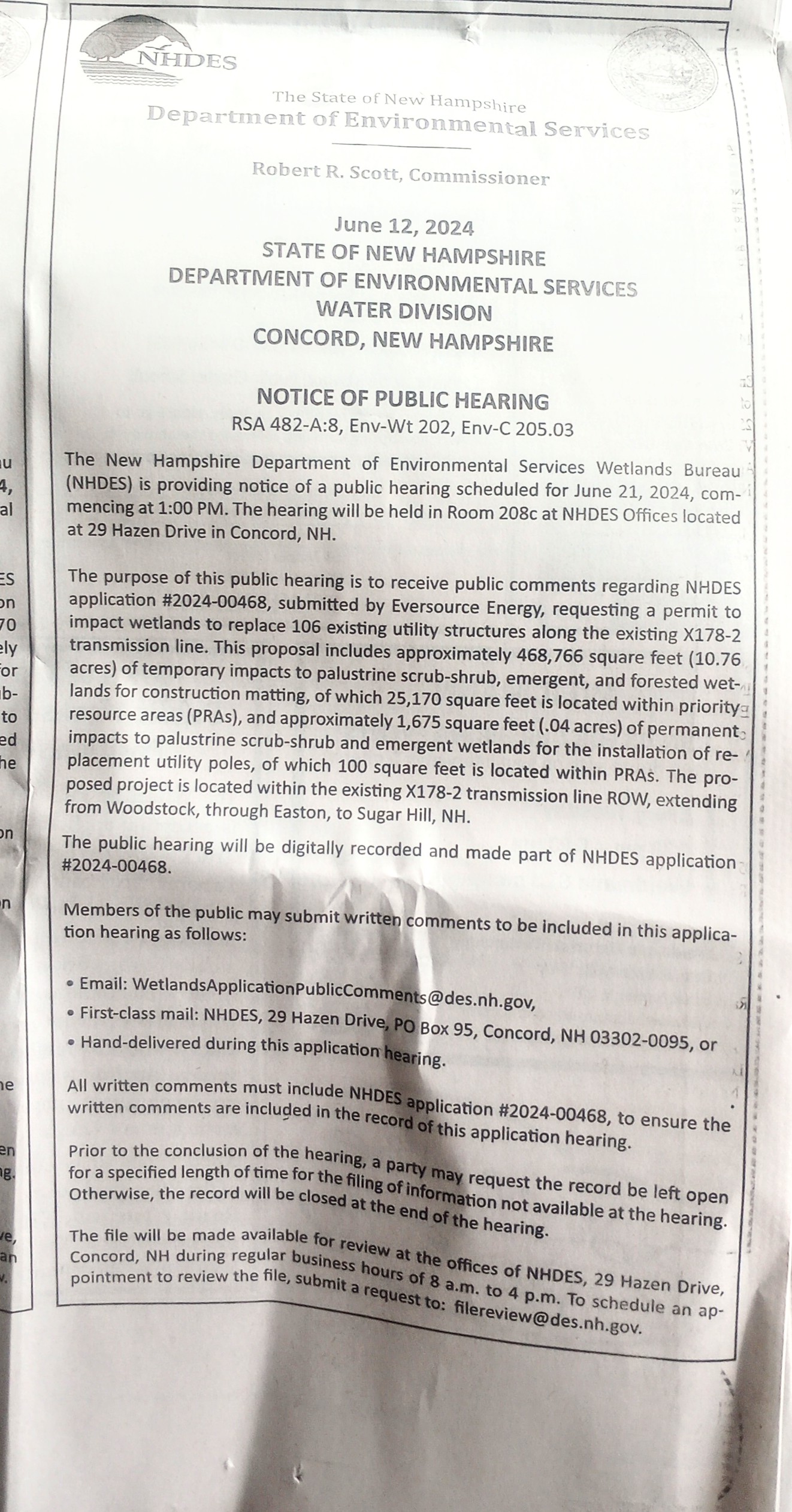

2024, June 21: NH DES hearing presentation
2024, June 21: recording of public meeting
2024, June 21: Letter to DES re DES ignoring its requirement that landowners sign AoT permits
2024, June 20: follow up presentation to PAC
2024, June 20: Minutes of PAC meeting, second presentation of X-178
2024, June 20: PAC agenda
2024, June: Acadia Center article on X-178.
2024, June 18: kp comment on ES Hobson's Choice presentation #2 to PAC
2024, June 17: Review by NH Department of Historical Resources, X-178(1)
2024, June 13: Letter to ISO-NE, PAC and Eversource re. FERC Order 1920 and need to cancel X-178
2024, June 12: Caledonian Record, legal notice, DES wetlands
2024, June 12: DES notice in Littleton Courier
2024, June 12: Eversource pre-follow up letter to PAC "The primary driver of the height increase is Rule 250D of the National Electrical Safety Code. Rule 250D was introduced in 2007 and currently requires that transmission lines in this area of New Hampshire be
designed to withstand 1-inch of radial ice with 40 mile-per-hour winds."
2024, June 11: X-178(1) follow up communication regarding recommended Fish & Game protections for Wood turtles. "Eversource has been very cooperative with NHF&G by agreeing to undertake a field survey within the ROW for potential overwintering turtle habitat areas, and engaging with NHF&G to develop protective, yet reasonable permit conditions."
2024, June 10: re. X-178(1) Aot permit application
2024, June 7: Eversource contractor VHB Response to DES Request for More Information – Standard Dredge and Fill Wetlands Permit Application
X178-1 Transmission Line Rebuild Project – Campton, Thornton, Woodstock, NH
2024, June 6: kp letter to DES, Eversource and PAC re. DES defining Eversource as the landowner of the easements.
2024, May 30: re X-178 Aot
2024, May 30: re AoT wetlands file, 1
2024, May 30: re AoT wetlands file, 2
2024, May 30: re AoT wetlands file, 3
2024, May 30: AoT Wetlands
2024, undated: CAMPTON ARM FUND WORKSHEET NHDES AQUATIC RESOURCE MITIGATION FUND WETLAND PAYMENT CALCULATION

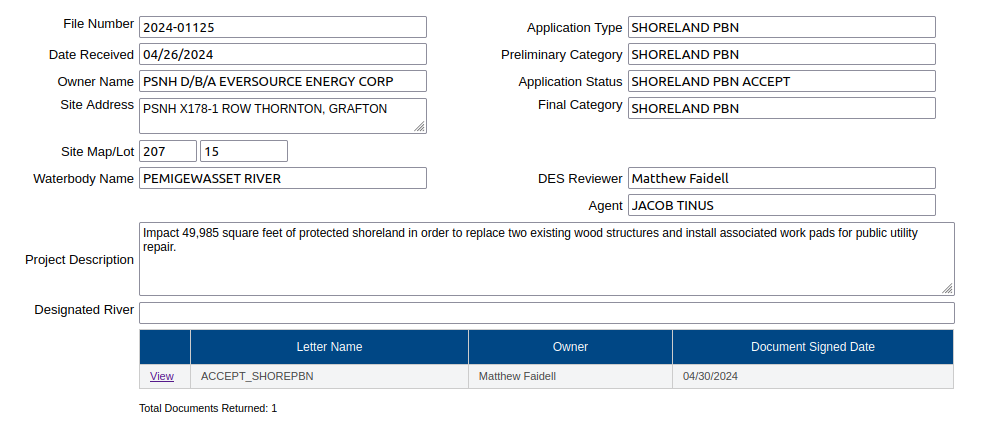

2024, May 29: X-178(1) AoT permit application
2024, May 29: X-178(1) AoT permit application
2024, May 29: X-178(1) Rebuild Project Additional Wetland Information Table
2024, May 29: X-178 (1) email re DES file
2024, May 29: X-178 (1) email re permit conditions
2024, May 28: X-178(2) Phase 1 impacts per AoT = 1,434,210 square feet aka 33 acres
2024, May 28: Eversource 2/3/2024 request for review by NH Division of Historical Resources of proposed construction of X-178(1). DHR writes: "We look forward to receiving assessment of effect tables for all resources eligible or listed to the National Register."
2024, May 24: DES issues permit for Alteration of 33 acres of Terrain on Section 2, Phase 1
2024, May 24: DES memo re X-178 line in Thornton Dump Landfill
2024, May 21: Caledonian Record article on petition to SEC (Sugar Hill did not join)
2023, May 16: Endangered Species list
2024, May 13: Minutes, Sugar Hill Selectboard re. petition to SEC

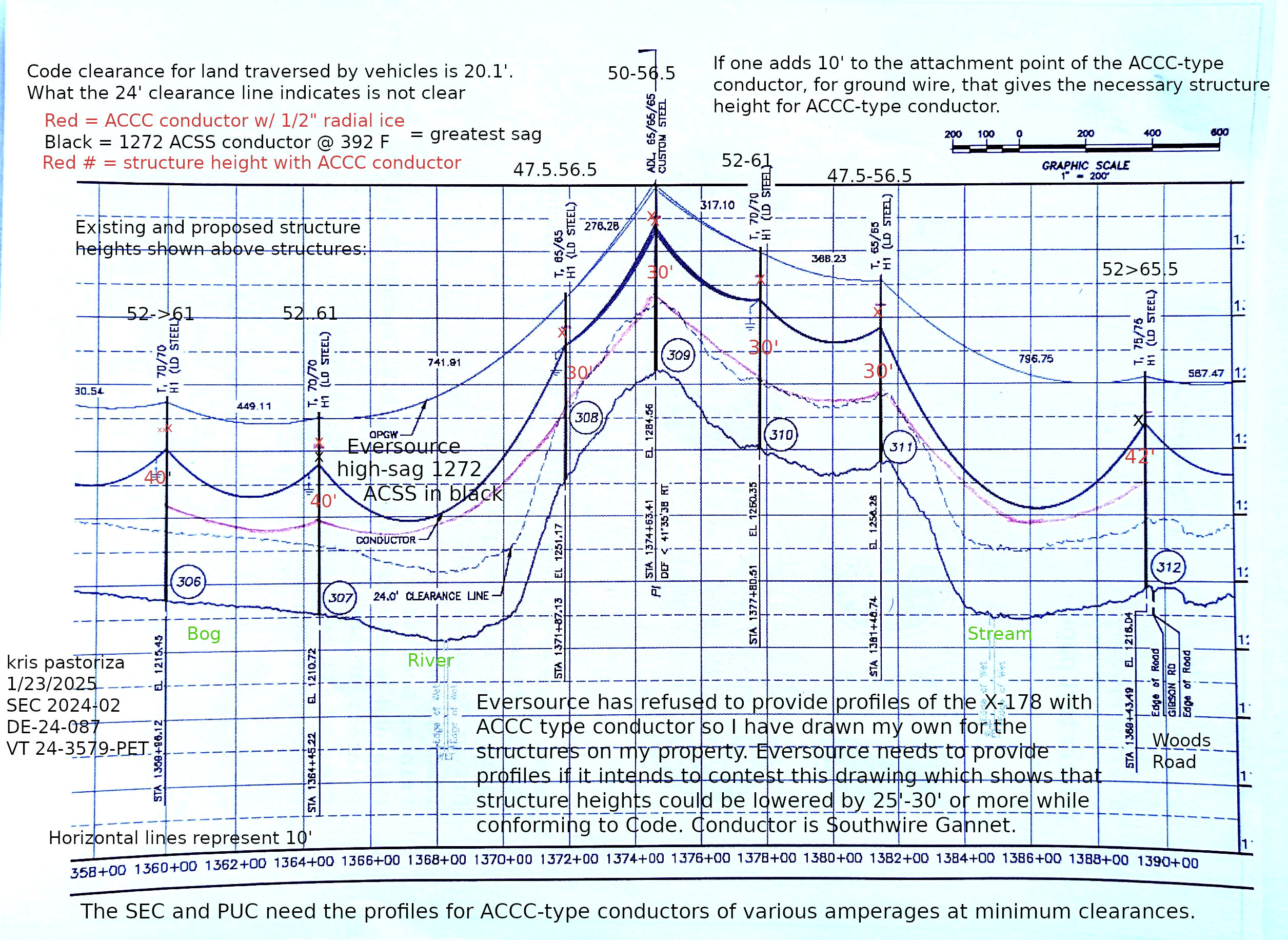

2024, May 12: k pastoriza letter to ES and PAC re proposed conductor clearances
2024, May 8: X-178 (1) extension agreement with DES, signed
2024, May 3: kp letter to FS re Russell Pond SUP
2024, May 1: DOT driveway permit cover letter

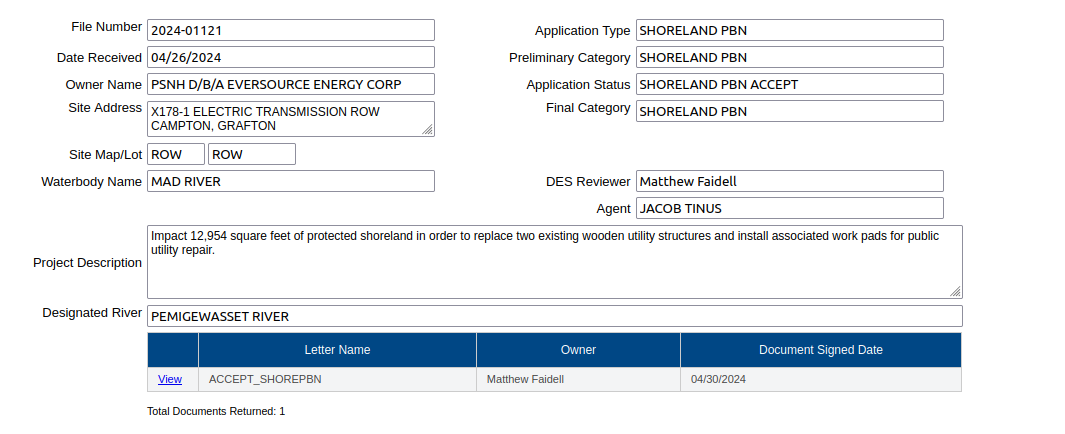

2024, April 30: DES issues permit for impacts to protected shoreland in Campton
2024, April 30: DES issues permit for impacts to protected shoreland in Thornton
2024, April 30: DOT driveway permit for easement
2024, April 26: k pastoriza letter to E$, ISO re new plan for X-178
2024, April: X-178 PAC presentation Annotated
2024, April 26: Eversource BMP violations
2024, April 26: Campton protected shoreland impacts
2024, April 26: Thornton protected shoreland impacts
2024, April 16: "Row Concern DES Permits" 1
2024, April 16: "Row Concern DES Permits" 2
2024, April 12: Eversource delays its May PAC presentation
2024, April 10: Comments by Jim Page
2024, April 10: Comments by Mike Kenney
2024, April 9: kp comment on rebuild as a response to claimed need to replace 41 out of 1160+ poles.
2024, April 7: comment on Eversource and FirstLight
2024, April 2: Eversource Small Projects Day application for line rebuild on Section 1 of X-178, Woodstock.
2024, April, 2: PAC responses to stakeholder comments
2024, April 1: DES to Easton notice of X-178(2) Phase 1 AoT application with cc to Sugar Hill and Woodstock. "Please provide a copy of this notice to all interested departments, boards and commissions."
2024, March 30: X-178-1; 77.4 acres excavated
2024, March 26: X-178 phase 1. Transcription of part of DES application for Alteration of Terrain. The AoT application was not sent to easement encumbered landowners and not given to the town in digital form
2024, March 20: kp letter to PAC and Eversource re. percent of category c poles
2024, March 20: kp letter to PAC re. OPGW
2024, March 20: Maine PUC comments
2024, March 18, k pastoriza question re structure locations (incorrectly dated)
2024, March 17: X-178 presentation to PAC, annotated
2024, March 15: NESCOE comments
2024, March 15: Dredge and Fill PRLAC comments
2024, March 14: Letter to PAC and WMNF commenting on 2016 pole removal project avoidance of wetlands damage
2024, March 15: k. pastoriza alternatives to project proposal
2024, March 9: k pastoriza request for Category C POLE locations
2024, March 7: Eversource request for NH Division of Historical Resouces review of X-178(1). Eversource states there are no buildings, structures (bridges, walls, culverts, etc.,) objects, districts or landscapes within the project area. DHR requests more information.
2024, March 5: proof of deliveries of X-178(3) hard copies
2024, March 4: DES to Sugar Hill notice of X-178(3) AoT application, with cc to Bethlehem. "Please provide a copy of this notice to all interested departments, boards and commissions."
2024, March: Eversource wetlands violations
2024, March 1: Fish & Game to DES: "NHB23-1568, NHB23-1711 X178-1 Transmission Line Rebuild Project NHDES Wetlands Standard Dredge and Fill, Alteration of Terrain NHFG Recommendations"
2024, March 1: Questions on X-178
2024, February 29: X-178(1)
2024, April 29: emails re Proof of transmittal X-178(3)
2024, February or March, posted after 2/28 PAC meeting: PAC "Guidelines" for public comments
2024, February 29: PAC meetings fail to ensure adequate project review
2024, February 28: PAC meeting; "While the transmission owners report asset condition projects to the PAC for informational purposes, the ISO does not have a decisional role in this area; these projects fall under a separate tariff administered by the TOs [transmission operators] under the jurisdiction of the FERC." ISO does approve asset condition projects for inclusion in costs passed on to rate-payers.
2024, February 28: minutes for February 28 PAC meeting with X-178 presentation, not posted on ISO PAC site until July 18, 2024
2024: Environmental Permitting Planset, Easton, no wetlands scientist stamp.
2024, February 28: Eversource presentation to PAC
2024, February 27: Questions on Eversource PAC presentation
2024, February 27: Easton Conservation Commission request for a 40-day extension for comment on Eversource's X-178 Wetlands Permit Application
2024, February 27: kp question on X-178 presentation to the PAC document
2024, February 27: kp letter to PAC; X-178 is not an asset condition project
2024, February 26 (dated): Eversource response to k. pastoriza questions.
2024, February 17: letter to PAC, ISO and ES re failure of X-178 to meet definition of asset condition project
2024, February 17: kp request to PAC to allot two hours for questions on Eversource's X-178 proposal to the PAC
2024, February 13: "This email is to acknowledge that the Bethlehem Conservation Commission (BCC) has notified the NHDES Wetlands
Bureau of its intent to investigate further the application included in File # 2024‐00297. The NHDES Wetlands Bureau will suspend action on the application until March 25, 2024 or receipt of a report from the BCC, whichever is sooner."
2024, February 5: proof of delivery to Ammonoosuc LAC with link to digital Wetlands Application. Eversource claimed AoT and Wetlands application were too large to send.
2024, February; Reel Brook Trail to be used as access road, pending WMNF approval, section 1
2024, February; Reel Brook Trail to be used as access road, pending WMNF approval, section 2
2024, January 25: Transmission owners database
2024, January 25: letter to Eversource re. transmission owners database
2024, January 18: kp questions on structure locations
2024, January 6, cover letter for wetlands permit application, Dalton
2024, January 3: Easton Conservation Commission draft minutes
January 6, 2024: Eversource presentation to Easton Conservation Commission with commentary
January 3, 2024: Eversource presentation to Easton Conservation Commission
2023, December 30: email to Forest Service and others notifying them of upcoming X-178 PAC presentation
2023, December 14: Comment on Eversource's doubling and quadrupling of conductor capacity in its "asset condition" projects
2023: smooth green snake flyer
2023, December 1: Fish & Game permit conditions X-178(3), Sugar Hill, Bethlehem, Dalton and Whitefield.
2023, October 20: email sent to Forest Service, AMC and Appalachian Trail Conservancy re Asset Condition problem
2023, October 10: email to Forest Service re. roadless construction
2023, October 5: Fish & Game and Eversource email
2023, October 1: Letter to Forest Service on Eversource rebuild of S-136 transmission line
2023, September 21: Letter to Eversource re. Asset Condition problem.
2023, September 15: Eversource request to NH Division of Historical Resources for review of X-178(1), states there are no buildings, structures (bridges, walls, culverts, etc.,) objects, districts or landscapes within the project area. DHR writes: "Please contact the DHR to further refine scope of architectural survey."
2023, September 11: Questions for Eversource PAC presentation
2023, September 7: Fish and Game and Eversource email
2023, September: first view of Bog Pond from east showing location of planned 750' x 100' permanent cleared and graded laydown area.

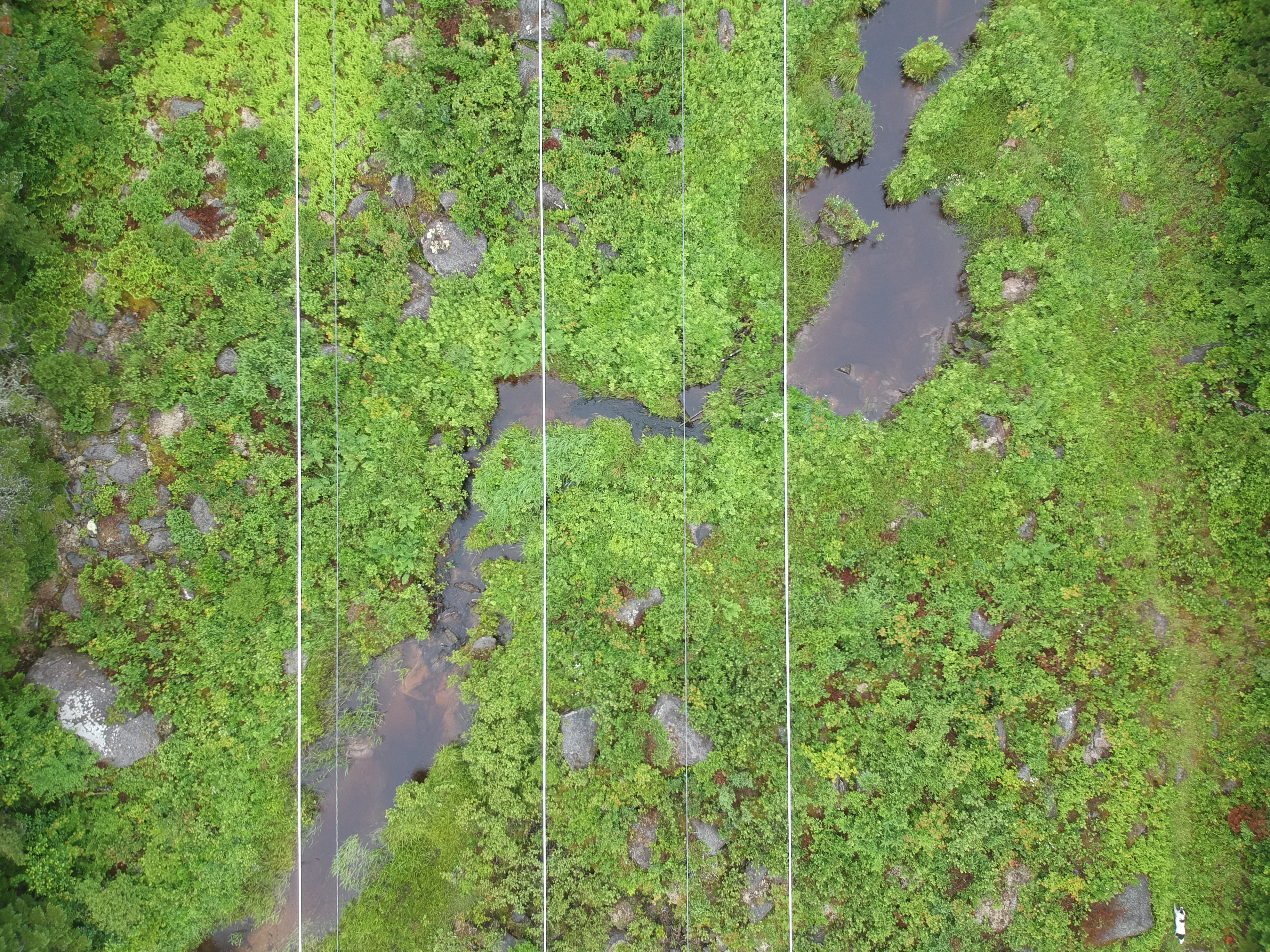

2023, September: Bog Marsh
2023, September: X-178 crossing of Bog Pond
2023, September: view of Lafayette
2023, September: view of Mt. Wolf
2023, September: Bog Pond and east side of Old Kinsman Notch. X-178 line below cliffs on left.
2023, September: X-178 line below Cliffs, and Bog Pond
2023, September: Bog Pond and X-178, South Kinsman behind
2023, September: Cliffs with X-178 below, and Bog Pond
2023, August 23: letter to PAC and Eversource

2023, August 1; Campton, Thornton and Woodstock DRAFT proposed construction plans
2023, August 1; North Woodstock to Sugar Hill DRAFT proposed construction plans
2023, August 1; Sugar Hill, Bethlehem, Dalton, Whitefield DRAFT proposed construction plans
2023, Inspection/Treatment tags on 1948 section of line

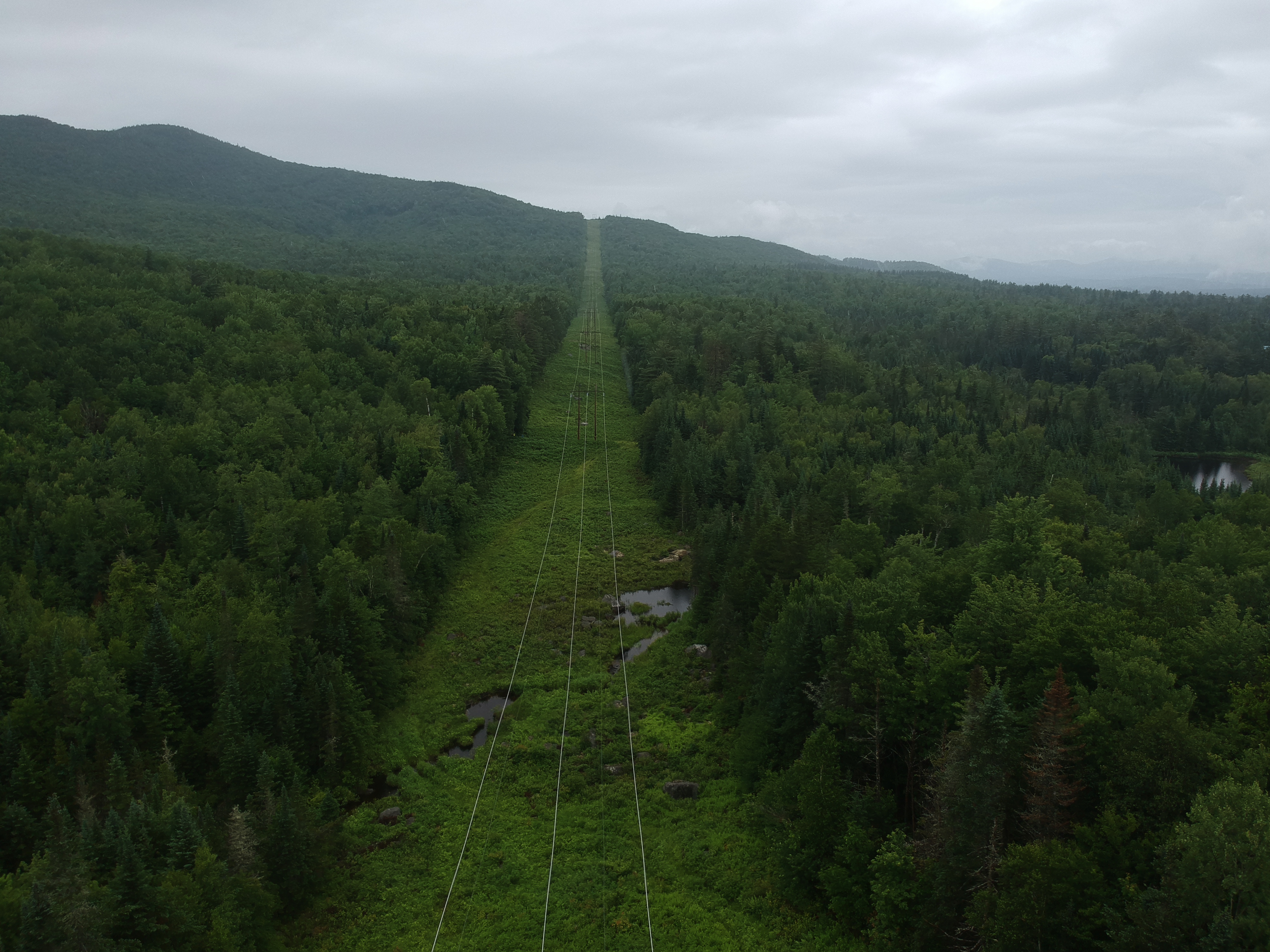

2023, July 3; drone image X-178
2023, July 23; drone image x-178 no road
2023, June 22: Natural Heritage Bureau datacheck email 1
2023, June 22: Natural Heritage Bureau datacheck email 2
2023, June; questions for Eversource
2023, May 24; response to Eversource answers to questions
2023, May; questions for Eversource

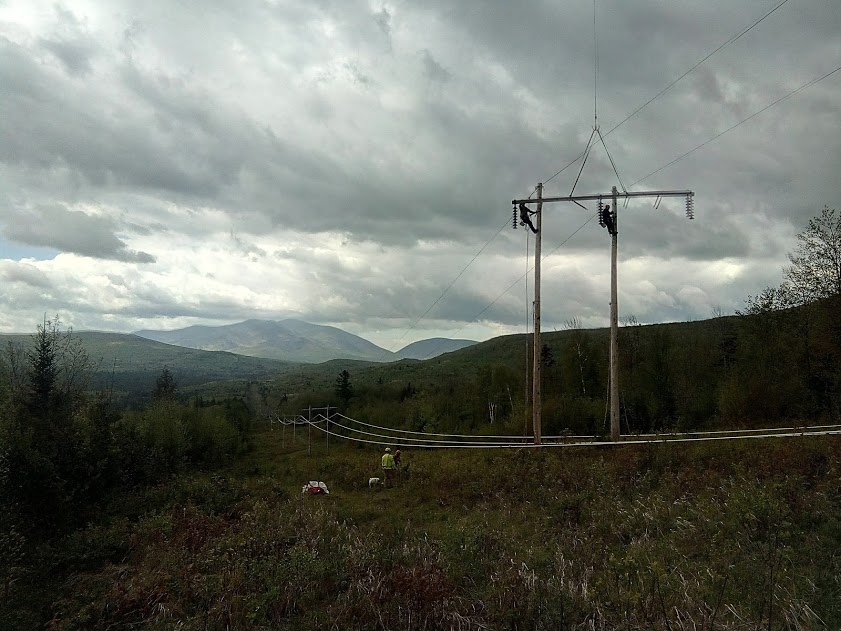

2023, May; photo of line
2023, May letter to ISO re X-178 and Asset Condition problem
2023, May 8-22: WMNF-E$ emails re permitting rebuild; "X178-2
140 structures to be replaced within the WMNF Some off right of way access required Wetland Impact: ~526,617 sq. ft. (~12.1 acres) Upland Grading Impacts: ~ 1,938,401 sq. ft. (~44.5 acres)"
2023, May 16: Fish and Wildlife letter re. endangered species
2023, April 22: "Dear Neighbor" letter
2023, April; Project Fact Sheet sent to landowners claiming reliability
2023, April 14; E$ to Easton: "The only request at this point in time is keeping it to municipal staff only while we complete additional outreach to the towns along this line from Campton up to Whitefield.'
2023, April 14; "Confidential" Project information sent with the email above.
2023, April 7: Project presentation to WMNF.
2023, April 13: Archaeological survey proposal, WMNF
2022, September 19: Survey Postcard
2021, February 18: Transmission line aerial overview plans, GZA
2020, January 30: Aerial overview plan
2019: ISO adds wording to OATT Schedule 12B #8.
2018, October 17: PAC meeting minutes
2018, October 17; PAC submission, replace 56 structures out of 570 at $11.2 million, later cancelled

2017, November 7: Helicopter patrols on Northern Pass route
2017 river crossing application, no mention of pole condition problems.
circa 2017 crossbar and insulator replacement
2016: Bog Pond Scenic Area proposal rejected by WMNF
2016: Bog Pond Scenic Area procedural history
2015, November 9: SPNHF letter to Easton re. property rights; "Further, the DES regulations require "[t]he applicant(s) or agent and the owner(s) or agent, if other than the applicant(s), [to] sign and date the application form." !d. 1503.10(a). Because the property owner of some of the route, the Forest Society, has not signed Nothern Pass's application, the application is incomplete. It does not include all the required signatures."
2015, October 19: Testimony for Northern Pass; "load has not required upgrade of remaining [336] lines"
2016: PAR report on removal of poles dumped in WMNF by PSNH during 1986 replacement, without roads or construction pads, of the 1948 line. This project was initiated by the Easton Conservation Commission. Eversource plans to build the new line and new permanent roads and construction "pads" in areas Eversource deemed too vulnerable for pole removal.
2015, July: work plan' "#1. Easton, Approximately 27 old poles to be removed. Debris located between X178 structure 266 and 291/ #2. Woodstock, NH, Approximately 41 old poles to be removed, Debris located between X178 structure 199 and 210 #3. Lincoln, NH, Approximately 147 old poles/pieces to be removed. Debris located between X178 structure 211 and 264"
Winco Lineman's safety manual
Winco Longline job hazard analysis
PAR helicopter requirements
PAR X-178 Health and Safety Plan
2015, July: PAR submittal: "If this project is awarded, PAR will longline several individuals into a ROW in order to cut up left over structure pieces and debris so they can be removed by the aircraft. Due to the lack of access, workers will need to be lowered into the ROW via longline...Workers will be transferred into different locations along an 8 mile stretch of ROW
being inserted and extracted by longline."

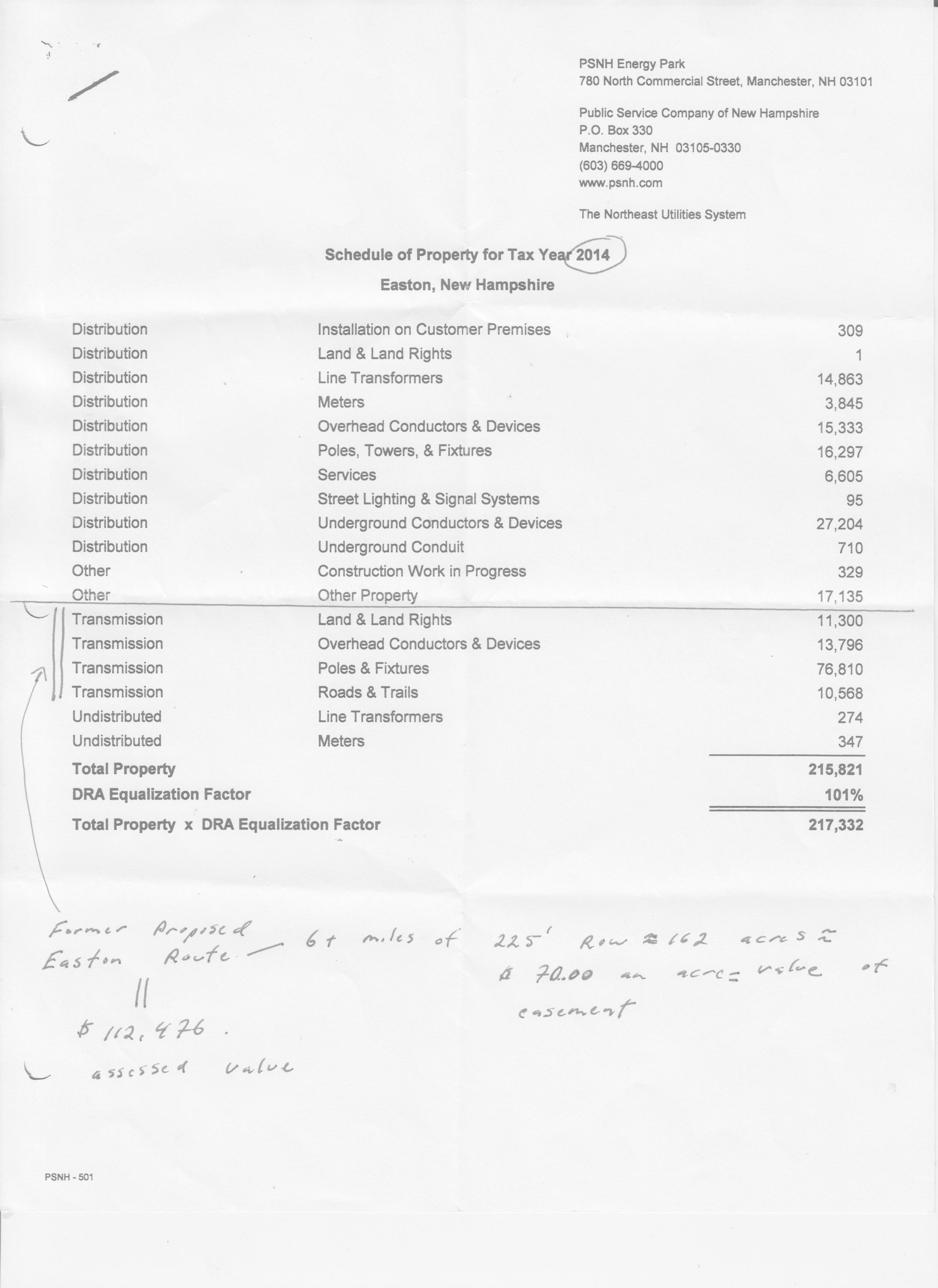

2014: Eversource valuation of ROW and infrastructure in Easton
2013, May 22: Northern Pass and WMNF Special Use Permit requirements
NP Special Use Permit info. for WMNF with map showing where Eversource has no ROW
2013; found poem: Muntz WMNF special use permit application
2013, January 29: Letter from NGOs and towns to WMNF;"United States Forest Service (“USFS”) regulations and guidance and the provisions of the WMNF Land and Resource Management Plan (“Forest Plan”)" include "the mandate that the project, given its proposed location within the Appalachian Trail management area, constitute the “only feasible and prudent alternative to meet an overriding public need,”"
2005?: White Mountain Roadless Areas. Kinsman: "The powerline corridor on the south boundary of the Inventoried Roadless Area is the most prominent non-conforming feature near the Inventoried Roadless Area. The corridor separates this Inventoried Roadless Area from the Mt. Wolf-Gordon Pond Inventoried Roadless Area. Its removal is impractical and unanticipated at this time."
Bog Pond area with poles dumped in 1986 "upgrade"
1948 pole Bog Pond area
Bog Pond area
2013, September 5: Northern Pass amended attachment to Special Use Permit
2008, March 31: Northeast Utilities (now Eversource) plans for Deerfield to Webster to Coolidge, Vermont 345kV line and Northern Pass
FEIS
2007 Special Use permit for .75 miles; upper Reel Brook Trail and two connecting trails/roads to the powerline. Good until 2036
2007 Special Use permit, Easton, Lincoln, Woodstock
2007 Special Use permit; Russell Pond, Horner Brook
1987 Pemigewasset crossing, North Woodstock
1986 'upgrade' paid for by Hydro-Quebec
Pesticides used on ROW until 1985

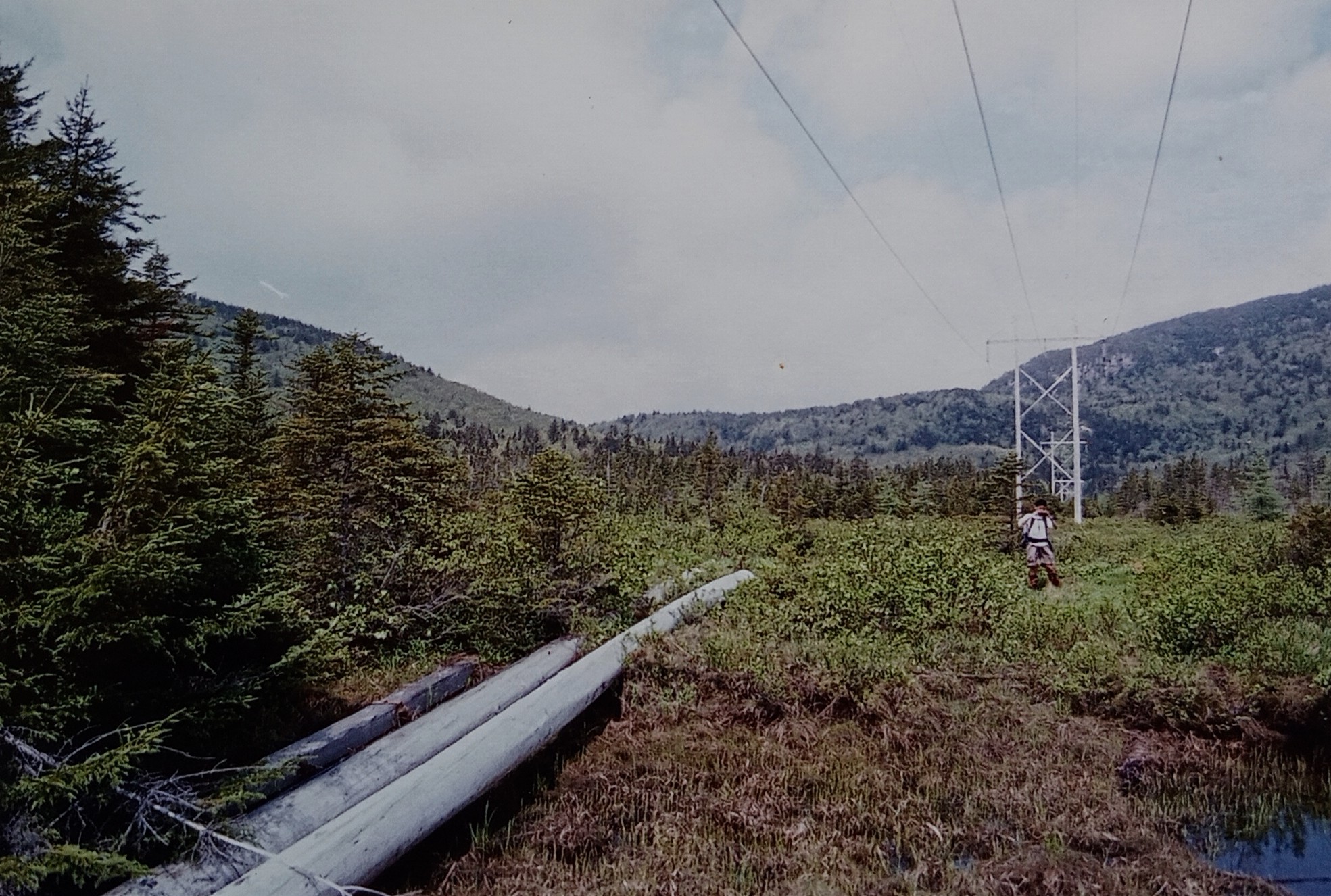

1970, November: powerline and easement before the 1985 rebuild, Easton, looking towards Reel Brook watershed. Herbicide spraying was done during this time.
1970, November 13: Special Use Permit for powerline in Woodstock
1970, March 25: FS to DOT re Special Use Permit for re-routed section of X-178 caused by I-93 extension north: "The lines should be planned, designed and constructed for the future anticipated needs of 345kV and 115kV and not to the present so that when the time comes, the necessary towers or poles will be in place and no added width will be needed."
1970, March 25: FS to DOT re Special Use Permit for powerline in Woodstock.
1970, February 19: Plymouth Record on powerline relocation
1970, February 10: Forest Service denies PSNH special use permit for new line
1970, February 6 through March 3; Forest Service and DOT documents re expansion of I-93 and relocation of powerline; "Due to increased demands for power, it appears that within a ten year period the combined existing 115kV and 69kV lines will be boosted to 345kV and 115kV and the existing 69kV line feeding northerly to Lincoln from the substation will be increased to a 115kV line."
1970, June 26: Union Leader article on powerline relocation; "...it has been projected that Public Service will have to provide twice as much electric power just eight years from now as the company is providing today."
1950 PSNH transmission map showing X-178

1948: portion of condemnation deed, Easton: "In order to meet the reasonable requirements of service to the public , it is necessary for the company to construct one or more 115kV transmission lines from Groveton, New Hampshire to North Woodstock, New Hampshire."

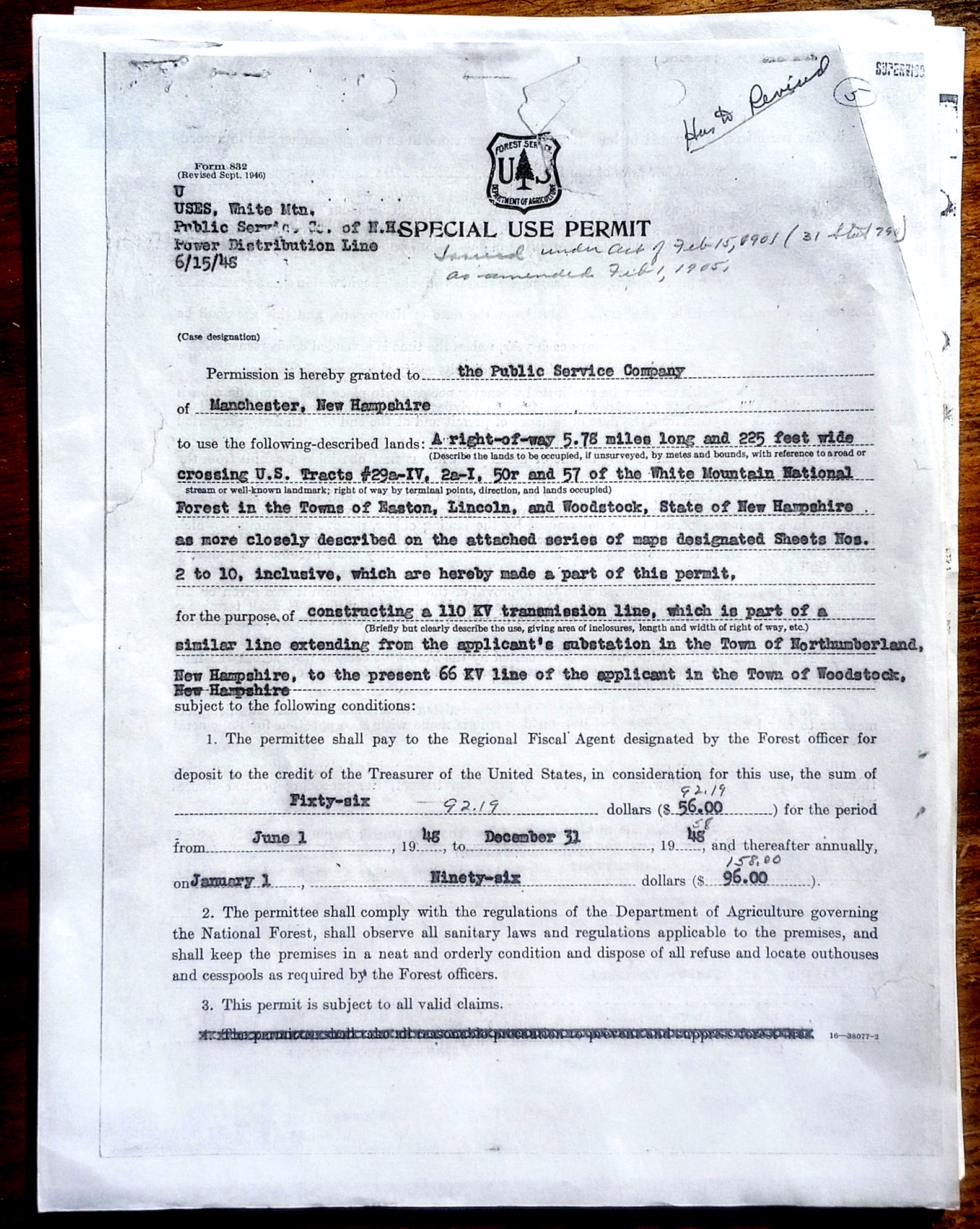

1948, June 15: WMNF SUP permit for X178, "part of a similar line from Northumberland to Woodstock"
1945: Forest Service suggests Bog Pond rather than Coppermine Trail

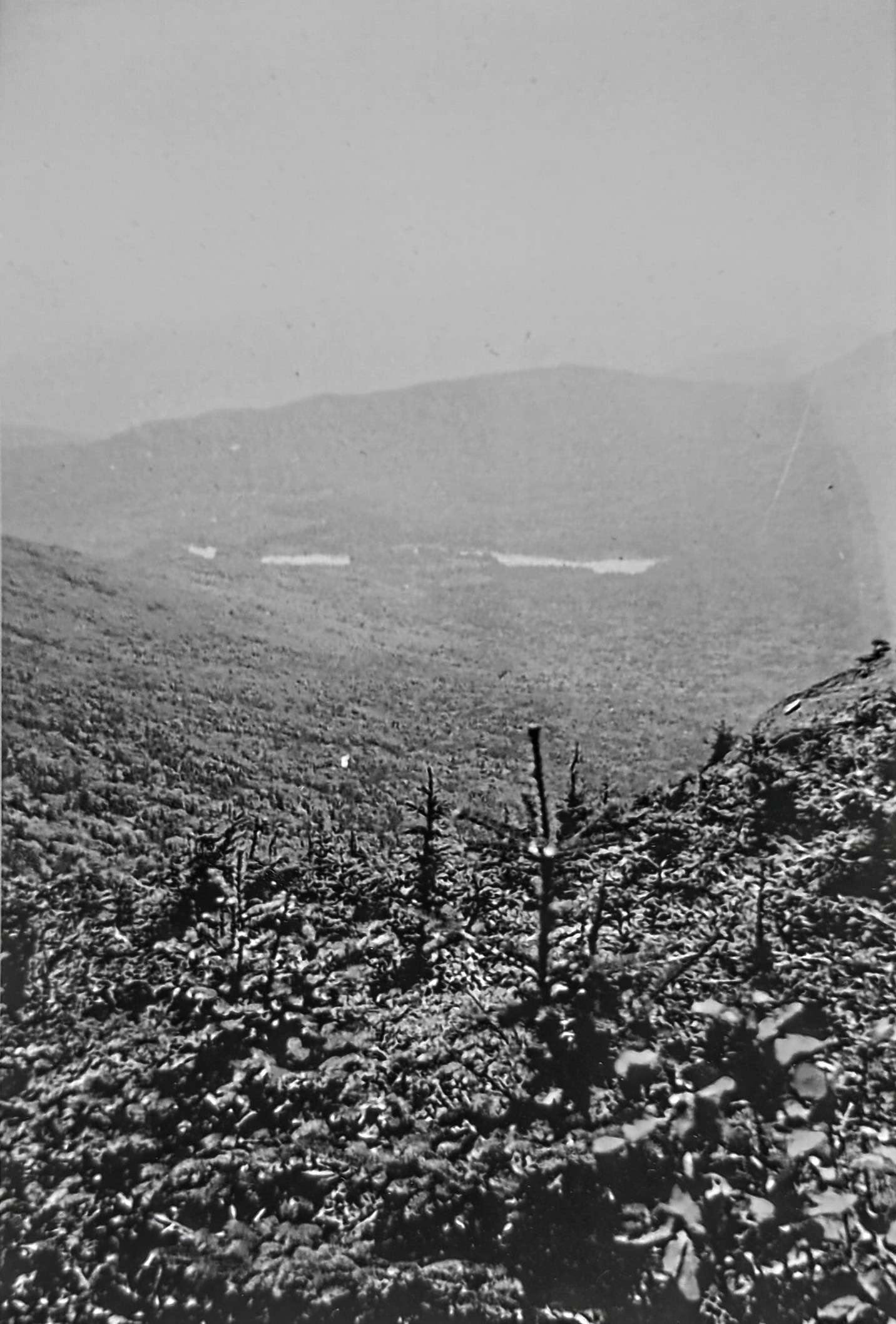

Bog Pond from South Kinsman before powerline
